The quick answer
Open Transactions > Manufacturing > Manufacturing Scheduler. In Work Center view each work center has a summary bar: green means it has operations that day, red means the operations overlapping that day ask for more time than the work center has available. Expand the red work center, hover each operation bar that falls on the red day, and read its dates and Estimated Hours in the Manufacturing Operation card. In the example the AUS-2 Stitching Cell is red on THU OCT 15 because two one-day operations of 5 and 4 hours share it.
The screenshots show sample data. Person and operating-company names are fictional. Use your own records and values when following the steps.
Before you start
The Manufacturing Scheduler is a SuiteApp, so it has to be installed and your role needs access to it and to the work orders. Operations only appear for work orders whose routing gives each operation a work center and planned times, and the available hours behind a conflict come from the work center's calendar, which the page does not show. The default Operation View is described as listing Released and In Process work orders, so a Planned work order may be missing until you choose a view that includes it. The page can be slow to load in a large account. In the account observed, each change of view took several seconds.
01. Open the Manufacturing Scheduler
Click Transactions > Manufacturing and choose Manufacturing Scheduler, the last entry in the menu. The page opens in Work Center view with Operation View set to - Default - and a window of October 14 - 27, 2026, one column per day. Four work centers are listed, each with its operations underneath, and the weekend columns are shaded as non-working days.
02. Read the summary bars and the legend

Each work center row carries a summary bar. Green, Operation Assigned, shows the days it has operations. The AUS-2 Stitching Cell bar is red on THU OCT 15, a Conflict. The legend under the chart explains the rest: yellow Not Started, blue Completed, orange Planned-Not Started and gray Non-Working Day. A red bar means the work center is over-allocated that day, not that anything in the data is wrong.
03. Collapse the work centers and open the red one

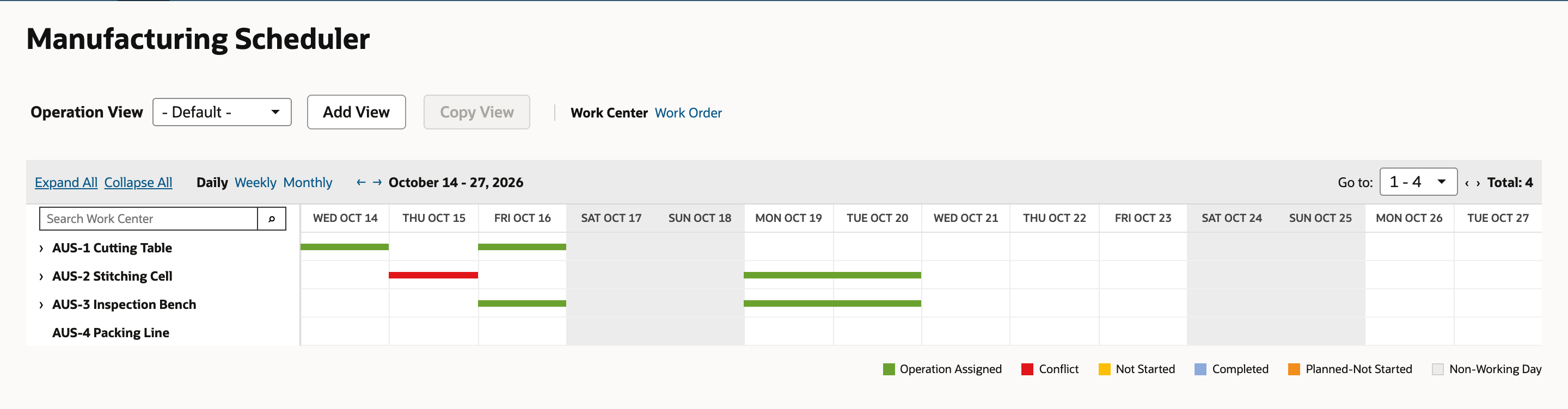

Click Collapse All. Only the four work center rows and their summary bars remain, which makes the pattern easy to read: green on the Cutting Table and the Inspection Bench, red then green on the Stitching Cell.

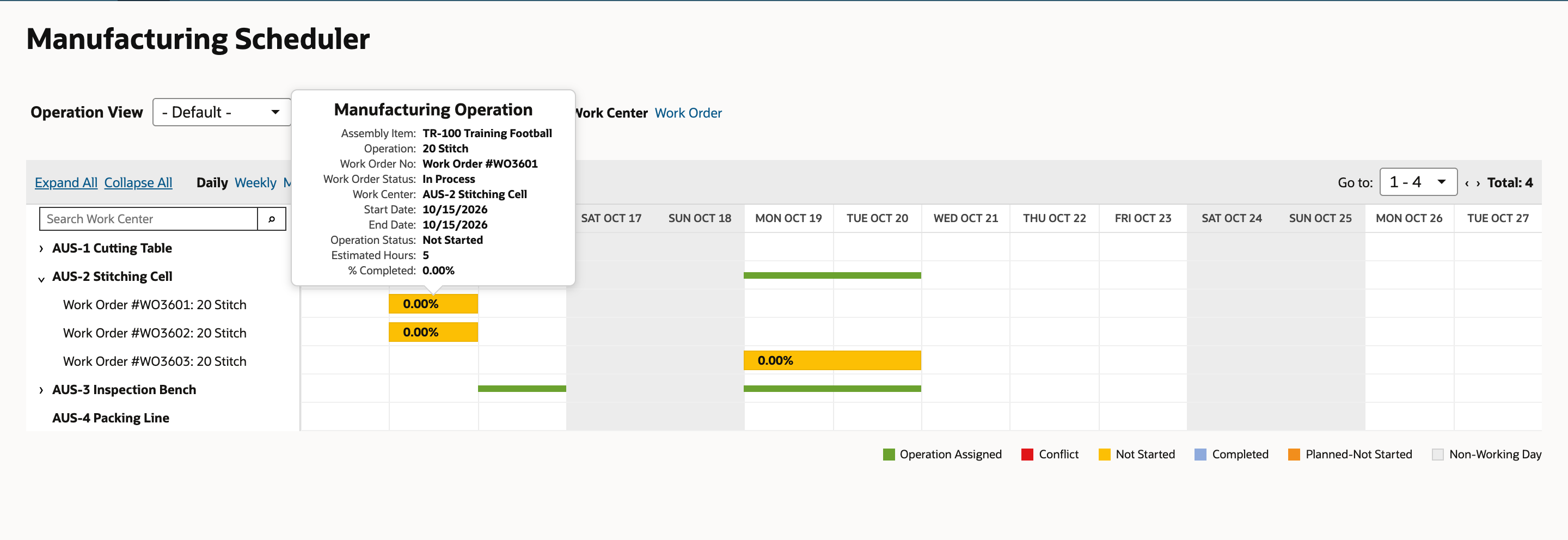

Click the arrow beside AUS-2 Stitching Cell. Its three Stitch operations appear: Work Order #WO3601 and #WO3602 on THU OCT 15, and Work Order #WO3603 on MON OCT 19 and TUE OCT 20. Each bar is yellow with 0.00% because nothing has started.
04. Hover the operations on the red day

Hover the bar for Work Order #WO3601 20 Stitch. The Manufacturing Operation card shows the assembly item, the operation, the work order and its status, the work center, the start and end dates, the Operation Status and Estimated Hours of 5.

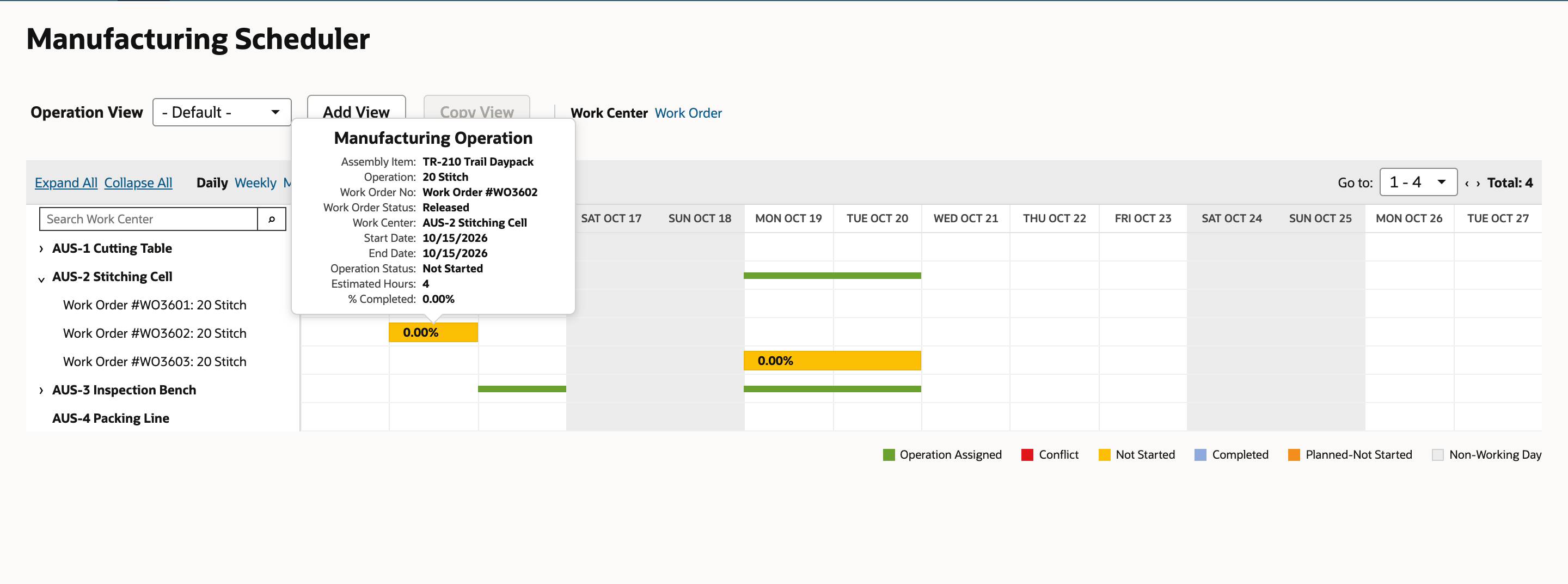

Hover the bar for Work Order #WO3602 20 Stitch. Its Estimated Hours is 4. Both are one-day operations on the same day, so together they ask for 9 hours, more than the 8-hour day assumed here, which is why the summary bar is red.
05. Switch to Work Order view

Click Work Order. The list now shows Work Order #WO3601, #WO3602 and #WO3603, each with its operations named for their work center, and Total reads 3. In the account observed this view had no summary bar on the work order rows, so a conflict only shows in Work Center view.
Check the result
- One work center has a red summary bar on a day, and the other work centers are green where they have operations.
- Expanding the red work center lists the operations that fall on the red day.
- The Manufacturing Operation card of each shows its dates and Estimated Hours, and the hours that land on the red day are more than the work center has available that day.
Common questions
What do the colors on the Manufacturing Scheduler mean?
Summary bars: green is Operation Assigned and red is Conflict. Operation bars: yellow is Not Started on a Released or In Process work order, blue is Completed, and orange is Planned-Not Started, for operations of Planned work orders. Gray columns are Non-Working Days from the work center calendar. In the account observed, only green, red, yellow, blue and gray appeared; orange was not on screen.
What causes a red Conflict bar?
The operations overlapping on that work center that day ask for more time than the work center has available that day. The available hours come from the work center's calendar, which the page does not show. An operation's Estimated Hours is for the whole operation, so one that runs over several days counts only part of it each day, and adding the full estimates can overstate the load. Whether completed operations count toward the load was not established here.
How do I find which operations cause the conflict?
Collapse All, expand the red work center, and read the dates of the operation bars that fall on the red day. Hover each bar and read its Estimated Hours. The red bar itself has no hover card, and it does not say which operation to move.
What is the difference between Work Center view and Work Order view?
Work Center view groups operations under their work centers and draws a summary bar on each work center, so it is the view for finding overloads. Work Order view groups the operations under their work orders and names each one for its work center. In the account observed it had no summary bar on the work order rows.
What does the hover card show?
The Manufacturing Operation card lists the Assembly Item, Operation, Work Order No, Work Order Status, Work Center, Start Date, End Date, Operation Status, Estimated Hours and % Completed. Summary bars have no card.
Why are some work orders or work centers missing?
The Operation View decides which work orders load. The default view is described as listing Released and In Process work orders, so a Planned work order may not appear unless a view includes it. Operations also need a routing with a work center and planned times, and a role with access. The page shows 20 work centers or work orders at a time, so use Go to or the Search Work Center box to find the one you want.
Can I reschedule an operation from the scheduler?
It is described as possible: in Work Center view you can drag an operation to another day or to another active work center in the same subsidiary, and double-click it to open its record. Moving the first operation of a forward-scheduled order or the last of a backward-scheduled one reschedules the others. That was not tested here, and it changes the work order's schedule, so try it on a test order first.
